|
CMC Metals Ltd.
(TSX-V:
CMB)
CMC Metals Ltd. is a
Canadian-based advance stage development mining company listed on the TSX Venture
Exchange (ticker symbol CMB) (US Listing: CMCXF.PK) (Frankfurt: ZM5). The Company has come to our attention due,
in part, to the exceptional opportunity afforded shareholders as CMB.V
will be Canada's newest silver producer utilizing their 100% owned
Silver Hart silver mine and mill set to come online in Q2 2010.
CMC Metals Ltd. was incorporated in 2005
with the purpose of acquiring a medium-size high grade precious metals
deposit that was well advanced in exploration, yet one that fell just
below the hurdle rate for most large corporations. Once acquired, the
plan was to advance the project to fruition.
Silver Hart Silver Mine and Mill, Yukon, Canada
100% owned
•
Production to commence in Q2 2010
|

Figure 1.

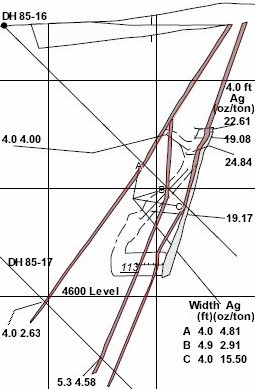

High Grade TM Zone Veins
The
TM zone alone contains an estimated high grade
silver resource of 6.5 million ounces (NI 43-101
inferred resource). |
The Silver Hart property is located in
south central Yukon, Canada in an area that contains numerous epithermal
silver-rich vein and replacement style deposits. Access to the property
is by a 42 kilometer all weather access road, 132 kilometers west on the
Alaska highway from the community of Watson Lake. The property is
comprised of 126 claims, covering and area of 2142 hectares.
In the mid 1980s the Silver Hart property
was significantly advanced, to the point where the former owners had
began the permitting process to take it to production, but for matters
unrelated to the merits of the property the project was put in abeyance
until 2005. With the assistance of well-heeled principles of CMC Metals
Ltd. the Silver Hart project was acquired for the benefit of
shareholders according to the aforementioned plan and now after a few
years of added exploration and development that plan is now at the point
of fruition and ready for production.
Silver Hart is a high grade silver
property averaging over 56.5 ounces silver per ton (1930g/t). The
historical resource (non 43-101) at Silver Hart is 9 million oz of silver, 17.6 million
lb’s lead and 58.6 million lb’s of zinc in the three zones and CMC
Metals is now in the advanced permitting stage on the project. By early
October 2009 the Yukon Environmental and Socio-economic Assessment Board
(YESAB) is expected to give CMB.V their development permits. CMB.V has
already performed improvements in support of development side including
mill pads, pressure area pads, the pit is completely stripped open, and
about 1500 tonnes of ore containing over an estimated USD$1,000,000 of metal is
stockpiled. An eight module prefabricated
80-tonne-per-day (TPD) mill is being constructed in Nevada with a
delivery date expected this fall and there is the potential to increase the
mill rate to 300 TPD with additional permitting and nominal capex.
The mill is currently ~75% complete. There
are several advantages to modular prefabrication in that it gives quick
up time for commissioning the mill, taking only ~30 days to mobilize the
mill, and at the end it also allows CMB.V to decommission the site
quickly and reuse that capital asset on another project.
There are several rate determining steps
in the process of gaining the operating permit. Logistically the water
permit takes six months after which the operating license can be issued.
For cost efficiency the final mobilization will take place once spring
thaw goes through, thus by the end of Q2 CMB.V will be in full
production.
The first zone to be surface mined will be
the 'TM', which contains an estimated high grade silver historical resource (non
43-101) of 6.5
million ounces, 11.5 pounds of lead and 19.9 million pounds of zinc.
During the first two years 50,000 tons of ore will be mined by open pit
methods prior to beginning operations below ground. The mill will run all
year long however the actual mining season is ~150 days/year, sufficient
ore to be stockpiled in that period. The above ground component is expected
to yield on average 1100gpt of silver and 7.5% lead and zinc. Mining MarketWatch on its own has calculated an
estimated breakeven silver cost of ~USD$4.45 per ounce
with base metals credited towards operating expenses (~$4.45/oz cash cost
of silver produced is net of smelter costs, labour, materials, and
supplies). Silver Hart is 100% owned and there is no royalty/NSR.
|

Figure 2. TM Zone and S Zone
CMC Metals has modeled the mining
approach. They will strip mine the TM zone down to the underground adit they
have now and there will be two locations where they will be
splitting the opening in the pit; one will drive an underground
drift over to the S zone, a stack fault that parallels the TM to
the northeast about 130 metres off the TM pit. CMB.V will continue following the vein heading NE. |

Figure 3. Donald Wedman, B.Sc.
(Engineering), P.Eng., President and CEO of CMC Metals Ltd. in
Mineralized TM Zone To Be Mined There
is a massive galena vein that runs through the zone; all of the
grey looking material is high grade silver-lead-zinc and the
buff coloured area is lesser but still potent mineralized rock. |
------ ------ ------ ------ ------
------
News July 29, 2009: CMC Metals Ltd.
Announces 41,900 Grams per Tonne intersection in the TM Pit
Preliminary test results from the trench
sampling in the TM pit at the Silver Hart Mine site. In preparation for
pre-production, the Company is conducting a detailed surface trench
sampling in the TM pit. The purpose of the trench sampling is to compare
the historical data to the more advanced analytical measurements from a
real-time XRF analyzer. The data will be used for excavation plans when
the pre-production phase of the mine starts... See full news
copy here.
------ ------ ------ ------ ------ ------
To date over $8.5 million has been spent
on exploration and infrastructure development on the Silver Hart
property – this includes over 8,834 m of drilling. The historical resource
(non 43-101) at Silver Hart is 9 million oz of silver, 17.6 million lb’s lead and
58.6 million lb’s of zinc in the three zones (TM, S, and KL zones):
|
Zone |
Tonnage
Tons |
Ag opt |
Pb % |
Zn% |
Ag oz |
Pb lbs. |
Zn lbs. |
|
TM |
116,322 |
56.5 |
4.97 |
8.59 |
6,575,655 |
11,562,407 |
19,984,120 |
|
S |
27,063 |
42.55 |
7.23 |
5.54 |
1,151,530 |
3,913,310 |
2,998,580 |
|
KL |
643,027 |
2.10 |
0.17 |
2.77 |
1,350,360 |
2,186,290 |
35,623,700 |
|
Subtotal- |
786,412 |
11.55 |
1.12 |
3.73 |
9,082,290 |
17,662,010 |
58,606,400 |
Strong Resource Expansion Potential
|

Drilling TM
Zone |
There is strong resource expansion/development
potential as there are over 20 known mineralized trench showings with
visible massive galena, with only three of the twenty zones having been
drill developed so far. Even the TM zone is open for resource expansion
as CMB.V does not know the depth of what the veins go; CMB.V will need
to do some deep drilling and determine if it makes economic sense to
ramp down when they go underground and start mining some of the deeper
veins. Also the S zone is a stack fault that parallels the TM to the
northeast and other trenches that have visible massive galena showings
with some drilling plus surface trench sampling include the F, M, B, K,
and KL zones. CMC has systematically drilled the F, M, some of the K,
and the KL zones to confirm the historical data and to expand the strike
length on the KL and M zones. All of the above zones are open in all
directions. There are also several linear geochem anomalies that haven't
been trenched or drilled to determine the extent of mineralization. The
linear anomalies also coincide with the same azimuth as the other known
mineralized fault zones. In the G-alpha zone which is ~1000 metres north
of the TM zone a slightly different depositional type of vein system
exists and there CMB.V management believes it too will offer several
years worth of mining of high grade silver along with lead and zinc.
Production in Q2 2010

Click to enlarge:
|

Location Map |

Silver Hart Mill Workflow |

TM Pit Plan |
|

Crusher Pad Construction |

Mill Pad Construction |

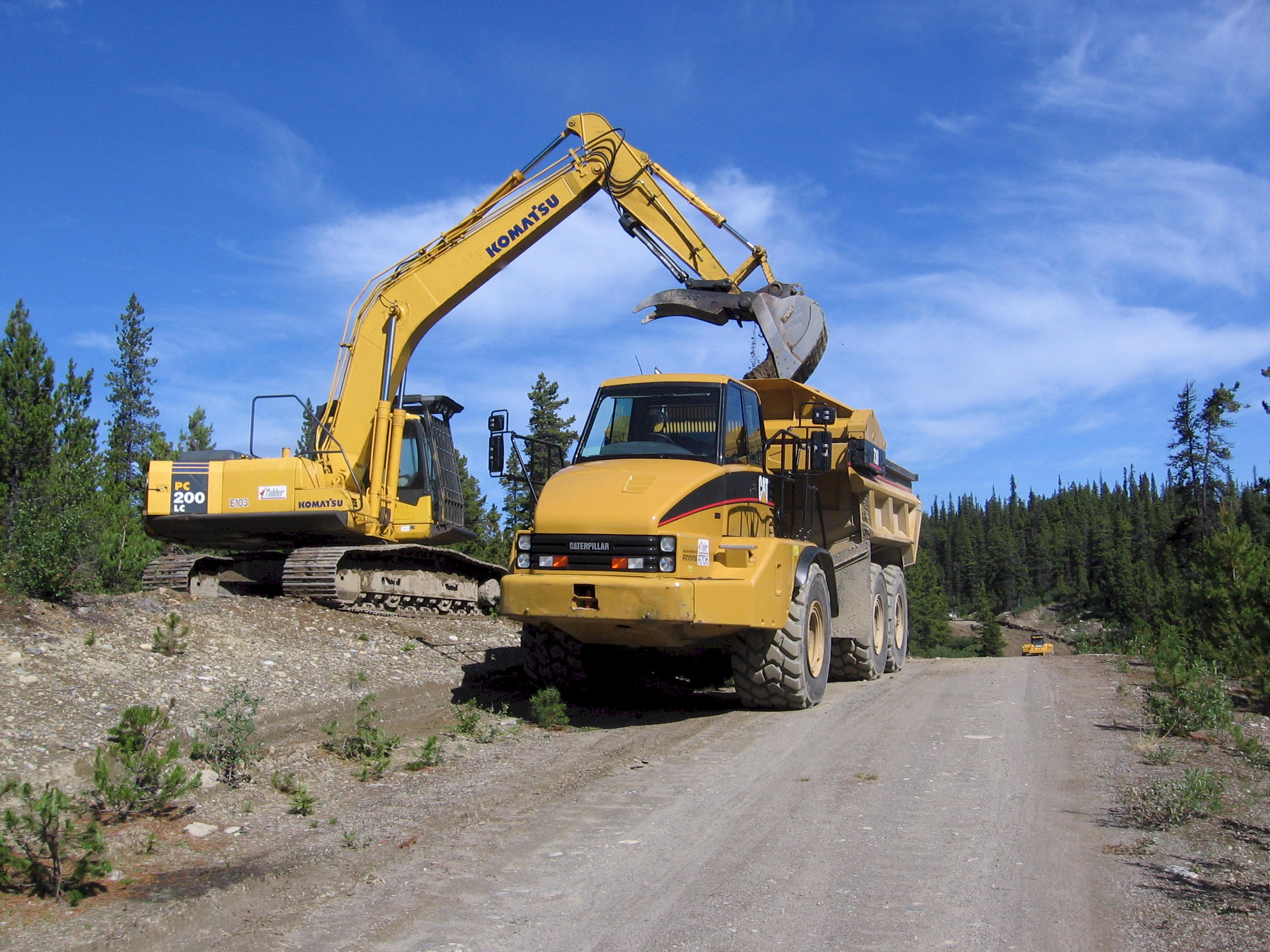

Predevelopment Road Work |

Test Mine Section & Stockpile |
|

Figure 11.

General Project Layout Plan
Click to enlarge |
In preparation for mining, last year
CMC Metals developed the civil infrastructure works, including the crusher pad
area, the crushed ROM crushed ore stockpile area, the mill facility area
and by-pass drainage, the waste rock dump site was prepared and the
majority of the TM pit area was stripped for the initial pit
development. CMB.V also conducted a test mining "trenching area" to test
the equipment productivity, dilution control protocols, and in-pit
mining approach to confirm economic mine model parameters.
Plans for the Silver Hart project during 2009 include the completion of
the Development Licence permitting, continued baseline data sampling,
installation of the mill foundation, preparation of the tailings pond
area, TM pit quality control sampling, infill drilling at the M zone,
and conduct a 1000 to 2000 tonne bulk sample. Depending on time
available, an expanded geochem soil survey may be conducted. Less than
6.5% of the CMC claims have been explored leaving a tremendous
opportunity for expansion.
The President and CEO of
CMC Metals Ltd. Donald Wedman, B.Sc. (Engineering),
P.Eng., was contacted by Mining MarketWatch Journal in
conducting research for this article. Donald
Wedman explained the aforementioned plan/modus operandi
in place at inception of CMC Metals in 2005 and how
Silver Hart is the first of the projects to move to a
significant cash flow position and advance the Company
without further unnecessary dilution. We were
particularly impressed with the clear intention to
ensure CMC Metals is in a position that you don't see
that very often with Jr. companies;
"We're essentially a Company that
is focused on developing properties to produce a profit
for the shareholders."
Success at Silver Hart
to be replicated at other advanced properties owned by
CMC Metals Ltd.
CMC Metals' President and
CEO provided insight into not only the upcoming
work at Silver Hart, but also how the other
advanced properties acquired by CMC Metals may be
brought to production down the road. Although the Wheelbarrow property
is a recent acquisition announcement, CMC Metals has
been working off and on site at Wheelbarrow for about a
year. Donald Wedman said "I
would speculate Wheelbarrow would be our next pipeline project,
mainly because it is very similar to the Silver Hart and
there is about four surface showings and it is
essentially straddled between the Adanac Ruby Creek
property and the Ruffner Mine which was a
past producer. The property has beautiful showings and
what we'll probably do is a couple years of infill
drilling and start our permitting process on that one
also. The Wheelbarrow would probably be our next one we
would seriously look at brining into production"
CMB.V could ship ore from Wheelbarrow to Silver Hart if
need be. |
Logjam
Property, Yukon, Canada
The Logjam Property is located in south
central Yukon, Canada in an area that contains numerous epithermal
silver-rich vein and replacement style deposits. Access to the property
is via an 18 kilometer all weather access road north of the Alaska
Highway kilometer marker 1216 or 200 kilometers east southeast of
Whitehorse.
The property is comprised of 32 claims. The area, in which the property
is situated, is underlain by a metamorphosed sedimentary sequence of the
Devonian-Mississippian Age intruded by a northwesterly striking band of
Diorite of the Jurassic-Cretaceous Age.
Mineralization on the Logjam property
consists of at least 10 northeasterly striking mineralized fracture
zones rather than clear cut massive quartz veins as has been suggested
in the past. The ten known silver-bearing structures strike
northeasterly across a northwesterly trending elongate diorite intrusive
that is about 450m in thickness. The possibility of developing numerous
hundreds of thousands of tons of reserves is good. Potential of the
property is thought to be in the million ton range. At least eight veins
are partially exposed on a steep cliff where they cannot be adequately
sampled. Six of the eight veins on the property have not yet been
sampled underground (in the favourable diorite). The underground
development has indicated that the veins have steep dips and can be
mined without timbering and with only minor dilution. It has also proven
that the mineralization extends through a vertical range of almost 250m
with no significant change in mineralogy or grade. Two of these veins (5
Vein and 6 Vein) have been explored underground where a number of
mineralized sections were located that averaged about 15 opt Ag, 0.14opt
gold and 6 percent combined lead and zinc across a thickness of 0.3 to
1.0m. The mineralized sections range from 12 to 35m in length and
represent from 12 to 57 per cent of the total length of vein drifted in
each heading within the favourable diorite. This deposit has the
advantages of excellent ground conditions and topographic relief for
underground mining, and a favourable location close to the Alaska
Highway. Adit development is feasible for at least another 200m
vertically lower (than the 5150 level).
Wheelbarrow Property, Yukon, Canada
The Wheelbarrow property is located 20 km
northeast of Atlin, B.C. The property comprises of four claims with a
surface of 1,489 hectares. There has been a substantial amount of
historical work conducted on the property since the original discovery
in the early 1900's. Over 3983 meters of drilling, extensive trenching,
geological mapping of host units, soil survey's, and air borne Mag and
VLF-EM was conducted over the entire property. The property boarders two
past producing mines plus the Adanac Ruby Creek property. There are
seven known mineralized zones that have been identified with high grade
silver. CMC is interested in continuing the drilling and sampling of the
zones to define the strike and depth of the mineralized zones for the
purpose of resource determination and a preliminary mine assessment. The
following are some of the trench and drill sample intervals that were
encountered by past exploration:
|
Sample ID |
Type |
Width (m) |
Silver
gm/tonne |
Lead % |
Zinc % |
Copper % |
Gold
gm/tonne |
Tungsten |
| Vulcan
Zone |
|
|
|
|
|
|
|
|
| 19792 |
Grab |
N/A |
9957 |
3.26 |
9.30 |
0.83 |
0.46 |
N/A |
| 19793 |
Grab |
N/A |
4638 |
1.80 |
14.65 |
1.46 |
1.49 |
N/A |
| |
|
|
|
|
|
|
|
|
| Wolf Zone |
|
|
|
|
|
|
|
|
| 19798 |
Grab |
N/A |
300 |
.49 |
.39 |
1.82 |
.23 |
2.41 |
| 19799 |
Grab |
N/A |
500 |
.25 |
.12 |
2.34 |
.17 |
1.77 |
| W07-KM04 |
Grab |
N/A |
3022 |
2.74 |
1.82 |
0.18 |
N/A |
0.02 |
| |
|
|
|
|
|
|
|
|
| Al Zone |
|
|
|
|
|
|
|
|
| AL07-RR05 |
Grab |
N/A |
1261 |
21.74 |
4.77 |
0.04 |
N/A |
0.04 |
| AL07-RR12 |
Grab |
N/A |
1801 |
33.63 |
4.83 |
0.08 |
N/A |
0.03 |
| |
|
|
|
|
|
|
|
|
| Big
Canyon S |
|
|
|
|
|
|
|
|
| BC07-04 |
Drill |
1.31 |
501 |
2.61 |
4.37 |
N/A |
N/A |
N/A |
| BC07-05 |
Drill |
1.39 |
498 |
3.58 |
3.10 |
N/A |
N/A |
N/A |
| BC07-06 |
Drill |
1.19 |
1392 |
1.27 |
3.23 |
N/A |
N/A |
N/A |
| BC07-07 |
Drill |
1.15 |
1007 |
0.87 |
7.20 |
N/A |
N/A |
N/A |
| |
|
|
|
|
|
|
|
|
| Brenda
Zone |
|
|
|
|
|
|
|
|
| E07-RR07 |
Grab |
N/A |
1109 |
0.47 |
1.58 |
N/A |
N/A |
N/A |
| BR07-KR17 |
Grab |
N/A |
1197 |
2.99 |
3.80 |
N/A |
N/A |
N/A |
| BR07-KR19 |
Grab |
N/A |
4028 |
9.96 |
2.50 |
N/A |
N/A |
N/A |
| |
|
|
|
|
|
|
|
|
CMC Metals is encouraged with the above
showings and will proceed to expand the geological understanding of this
deposit through additional exploration. For the 2009 season CMC Metals
is proposing to continue to assemble the historical data, surface trench
outcrops, strike and depth drill at least one showing, and geologically
map the data. Don Wedman P.Eng., CEO and President of the Company
commented "We are very please with the
opportunity the Wheelbarrow property presents for the Company. The
demonstrated grades and showings fits well with our Company focus of
high grade silver developments. In addition, the semi-mobile mill being
fabricated for the Silver Hart project would have the capability to
process ore from this site. We will prepare this property over the next
few years for feasibility assessment and development."
Exploration permitting will begin immediately with the target of
starting a on the ground investigation this July.
CMC Metals'
Management & Technical
Leadership:
Skip to top
The current board of directors are a well rounded
combination of people that each contribute expertise in
disciplines necessary for a successful mining entity:
Donald Wedman, B.Sc. (Engineering), P.Eng., President
and Chief
Executive Officer
Mr. Don Wedman received a Bachelor of Science, Mining
Engineer, at the University of Alberta. He has over 25
years experience in mine feasibility assessments,
development, and environmental permitting. His project
management skills are an asset in moving exploration
properties into the development/production stage. From
1981 to 1997 he was a Senior Engineer with Alberta Power
Limited (ATCO Power) managing fuel contracts, contract
negotiations, and conducting mine resource assessments.
In 1998 he joined Geographic Dynamics Corp. as the
General Manager, for project managing environmental and
ecological resource assessment studies. From 2003 to
2005 he also was the Vice President of Coremetric
Development Corp., assisting in the development of the
first iron quarry in Alberta. He has served on a number
of volunteer boards including APEGGA Career Committee
(Chairman), and the Edmonton Branch of CIM.
Michael Scholz, B.Com., LL.B., CFO and
Director
Mr. Michael Scholz received both a Bachelor of Commerce
(B.Com.) and a Bachelor (LL.B.) of Law from the
University of British Columbia. From 1978 to 2001 he was
Solicitor and Senior Partner of the law firm Alexander
Holburn, and is a member of the BC bar. He is a director
and Chairman of Avcorp Industries Inc., a director of
Uniserve Communication, and from 2001 to 2004 was
President, Vice Chair and director of Great Canadian
Gaming Corporation.
Steve Mathiesen, B.A. (Economics/Commerce), LL.B, Director
Mr. Steve Mathiesen has been a business lawyer for 25
years and is a partner with Lang Michener LLP, in its
Vancouver office. His practice includes acting for
public and private companies in mergers and acquisitions
and in financings. Steve was the founder of CMC's
predecessor company.
Jacob Brouwer , Director
Jacob Brouwer is the Chairman and Chief Executive
Officer of Brouwer Claims Canada & Co. Ltd., an
insurance adjusting firm, and is the founding director
and Chair Emeritus of Bank West Inc., Governor of both
the YMCA, Vancouver, BC, and the Vancouver Aquarium and
Member of its Finance Committee. Mr. Brouwer is a
Charter Member of the International Institute of Loss
Adjusters Inc., world headquarters in Chicago, Illinois,
and a member of the B.C. Premier's Fund Raising
Committee and Federal Conservative Fund Raising
Committee. In addition to Mr. Brouwer's many
accomplishments, Mr. Brouwer has sat on the Board of
many commercial, public and other organizations during
his reputable career and brings to the Company his many
years of business experience.
Jatinder (Jack) Bal , Director
Jack Bal is a business executive, with over 11 years of
experience in the resource industry and public markets.
His contacts in several international countries known
for precious metal mining are invaluable in identifying
potential property acquisitions for CMC. Mr. Bal was the
founding member and Vice President of Apparo Software
Inc., past Director of Saintstar Ventures Inc. and is
currently a Director of Eaglestar Ventures Inc. and
President of Journey Resources Corp.
Daryl Pollock, Director
Daryl Pollock graduated from the University of Manitoba
with a B. Comm (H) and has since enjoyed 35 years of
business experience in marketing and investment related
endeavors. More recently he served as President and CEO
of Olympic Resources Ltd. from 1992-2002, prior to its
merger with Whittier Energy Corp., with whom he sat as a
Director. Mr. Pollock is currently involved in a variety
of early stage development projects, primarily related
to Alternative and Clean Energy.
Note: This list is not intended to be a complete overview of
CMC Metals Ltd. or a complete listing of CMB.V's projects, Mining
MarketWatch urges the reader to contact the subject company and has
identified the following sources for information on CMC Metals Ltd.:
For more information
contact Gord Zelko, VP Business Development at:
Ph (250).495.7123
E-mail:
contact@stoxnetwork.com Company's web site:
www.cmcmetals.ca
SEDAR Filings:
URL
|
|
|
![]() |
|
|
